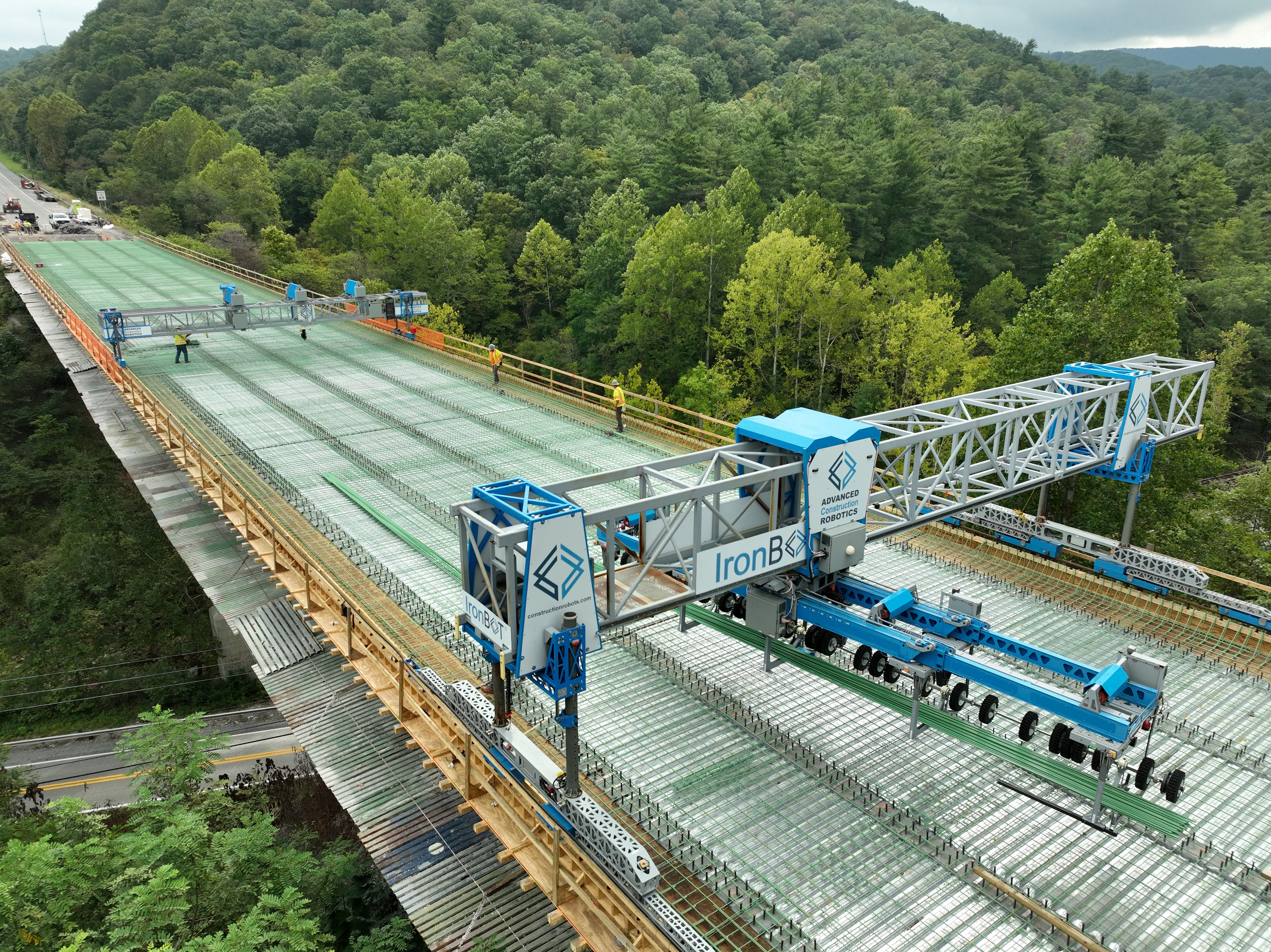

East Bound Oakvale Bridge, WV

Read Time:
5
min

Project & Crew Information:

  • General Contractor: Brayman Construction Corporation
  • Rebar Contractor: N/A (Self-Perform)
  • Union: IW Local 787
  • Crew Size: 8-person
  • Shift Duration: 10-hour
  • Products Used: TyBOT & IronBOT
  • September 2026

‍

ACR Project Scope:

  • 4-Span Bridge Deck
  • Bridge Deck SF: 20,915
  • Width:44.5’
  • Length: 470’
  • Total Deck Rebar: 162,390 LBS
  • Required Tied Intersections: 39,181
  • Tie Specs: 50% Bottom / 50% Top

‍

TyBOT Performance Metrics:

  • Actual Ties: 29,316 (75% Total)
  • Active Production Hours: 28.29
  • Active Tie Rate: 1,036 Ties/HR
  • Total Equipment Hours: 46.23
  • Active Production Rate = 61%
  • Equipment Utilization Rate = 57%

‍

IronBOT Performance Metrics:

  • Actual Pounds Placed: 159,826 (98% Total)
  • Active Production Hours: 39.5
  • Active Placement Rate: 4,046 LB/HR
  • Total Equipment Hours: 60.5
  • Active Production Rate = 65%
  • Equipment Utilization Rate = 64%
Budget w/o ACR Actuals w/ACR Increase / (Decrease)
Productivity (LB/MH) 180 378 110%
Customer Crew Manhours 900 423 -53%
Duration (Shifts) 12.5 7 -44%
Manpower (FTE) 9 8 -11%
No items found.

Heading 2

  • Item A
  • Item B
  • Item C

Text link

Bold text

Emphasis

Superscript

Subscript

Discover Our Rebar Robots

Explore how TyBot and IronBot can revolutionize your rebar installation process today.

TyBOT autonomous rebar tying robot on a bridge deck, viewed from the side
